This process encompasses navigating the Project/Activity Milestone Schedule screen.

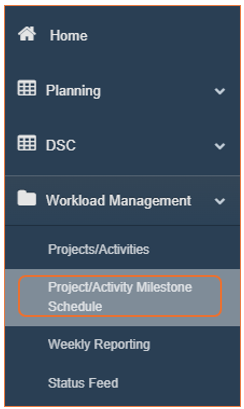

1. To access the Project/Activity Milestone Schedule screen, select the Project/Activity Milestone Schedule option from the Workload Management menu on the left.

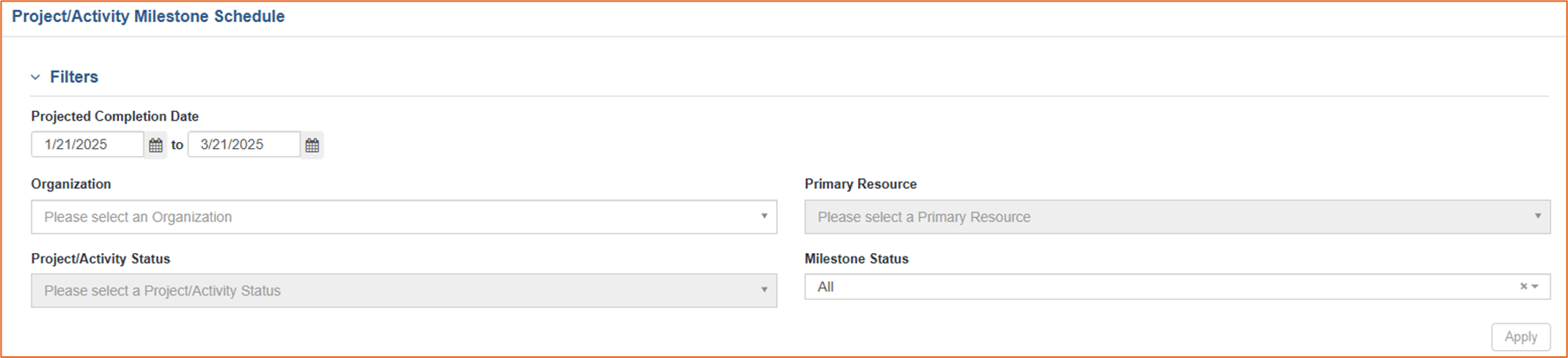

2. The Project/Activity Milestone Schedule screen will open to a series of filters which must first be applied to view underlying data.
- By default, the Projected Completion Date range for milestones has a start date of the current date and an end date 2 months out. This can be updated as needed.
- The Organization filter will open and only display Organizations that have milestones with Projected Completion Dates falling between the selected dates.

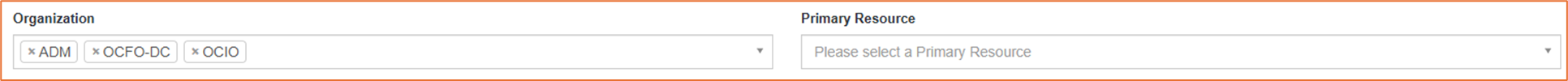

- When one or more Organizations have been added to the filter, the Primary Resource filter will open. Select one or more options from the filtered list provided.

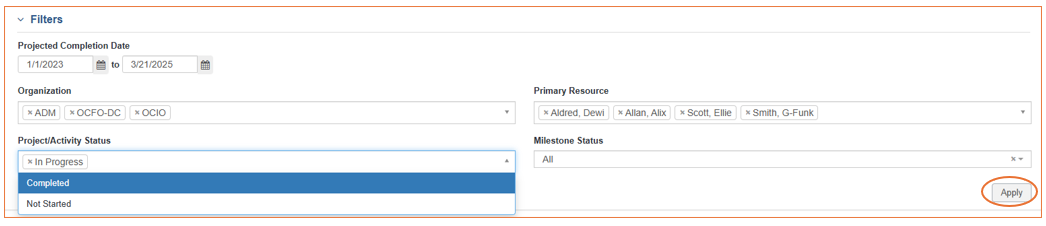

- Select desired Project/Activity and Milestone statuses and select 'Apply'.

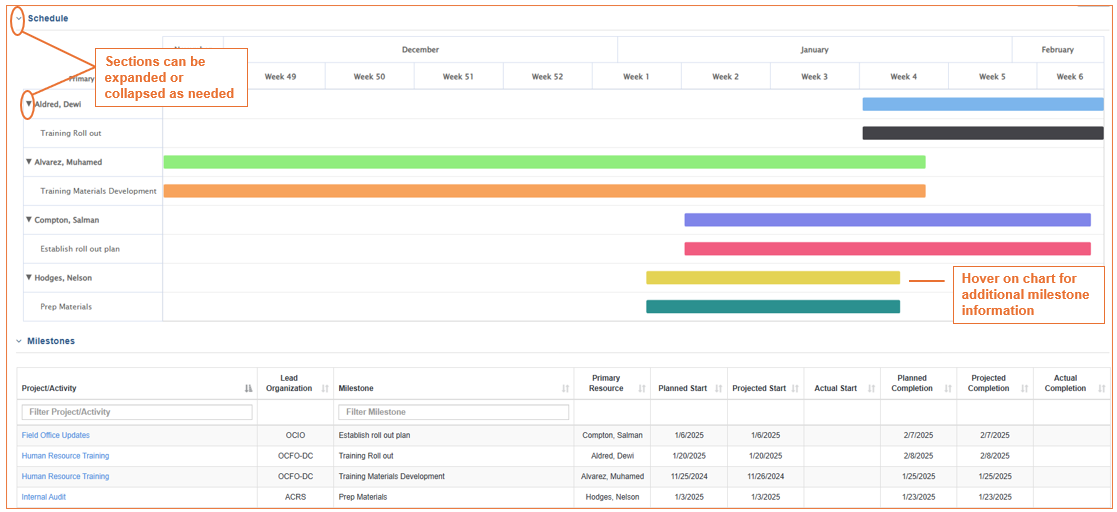

3. A schedule Gantt Chart and table of Milestones will be returned based on the applied filters.
- The Schedule and Milestones sections can be expanded or collapsed as needed by selecting the adjacent arrow/carrot by section header.
- Milestones can be displayed or hidden by Resource on the Gantt chart by selecting the adjacent arrow/carrot by Resource name.
